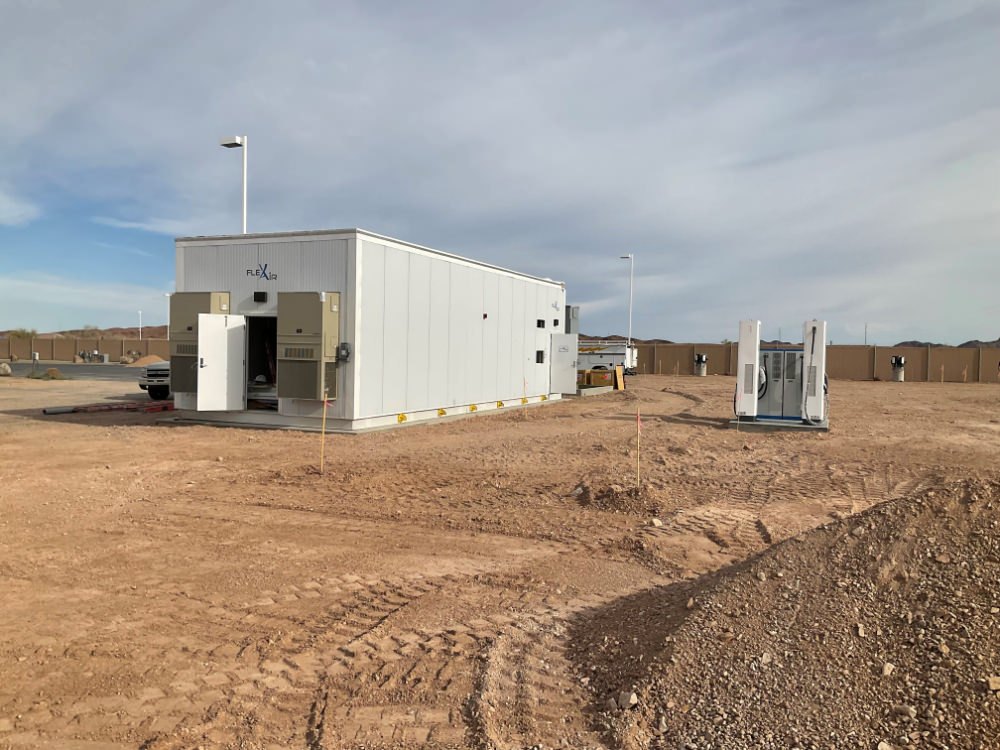

Description
Battery Charging Sub Station.
Location
GM Proving Grounds – Yuma, Arizona
Challenge
Complete the substation 4 weeks after gear arrival. The electrical equipment was delayed in manufacturing by the gear manufacturer, and the general contractor needed to turn the project over to GM within 6 weeks of receiving gear.
Solution

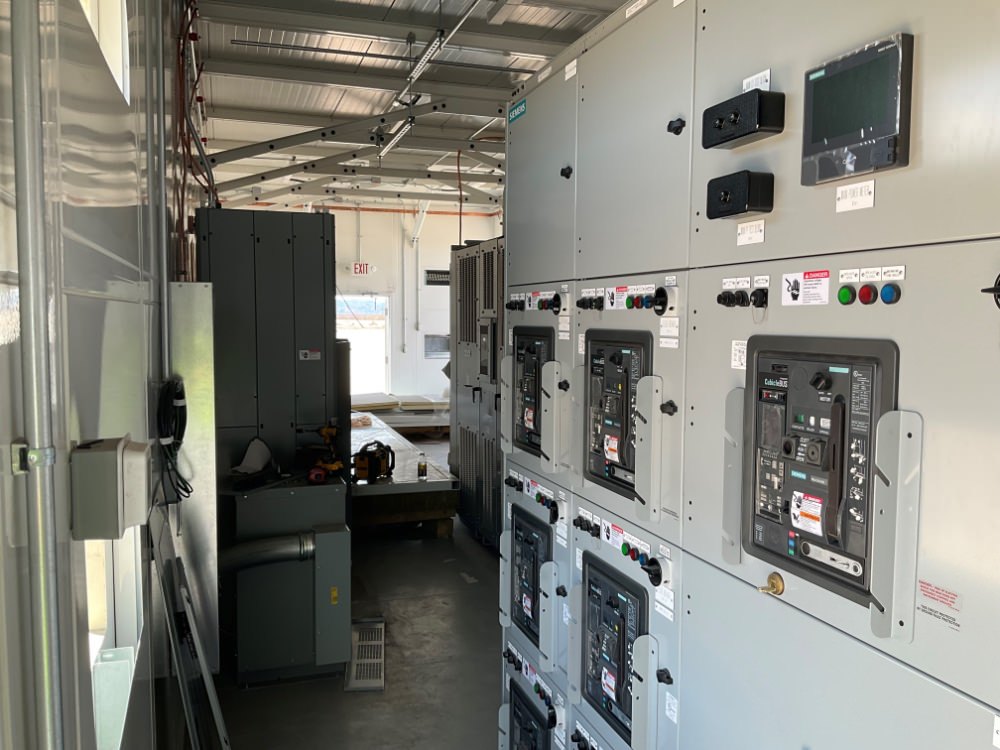

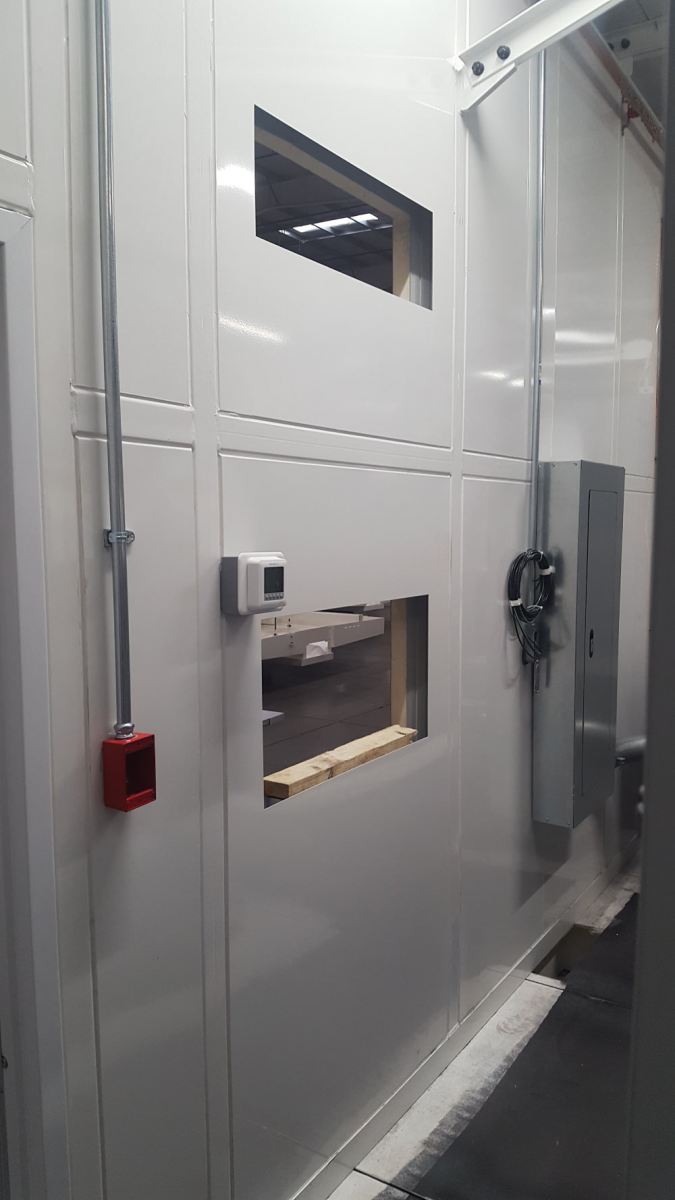

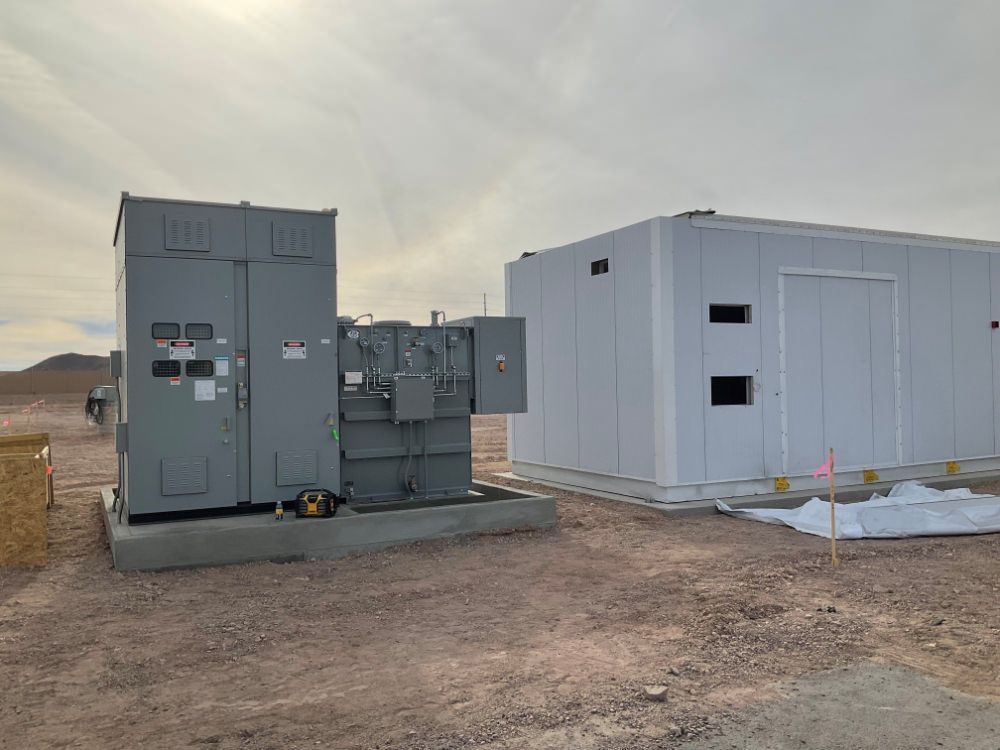

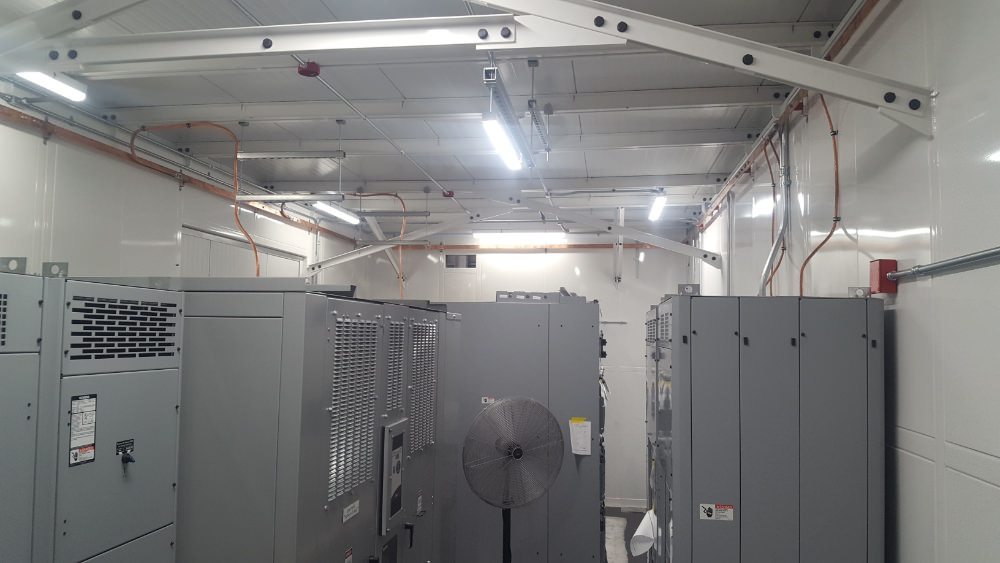

⦁ Flex Air designed and engineered a modular enclosure for the gear.

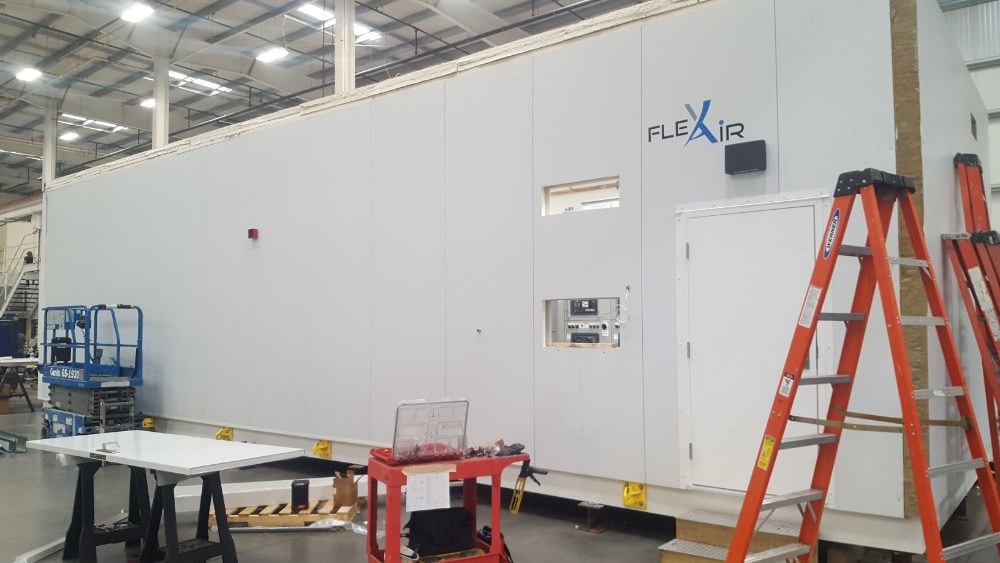

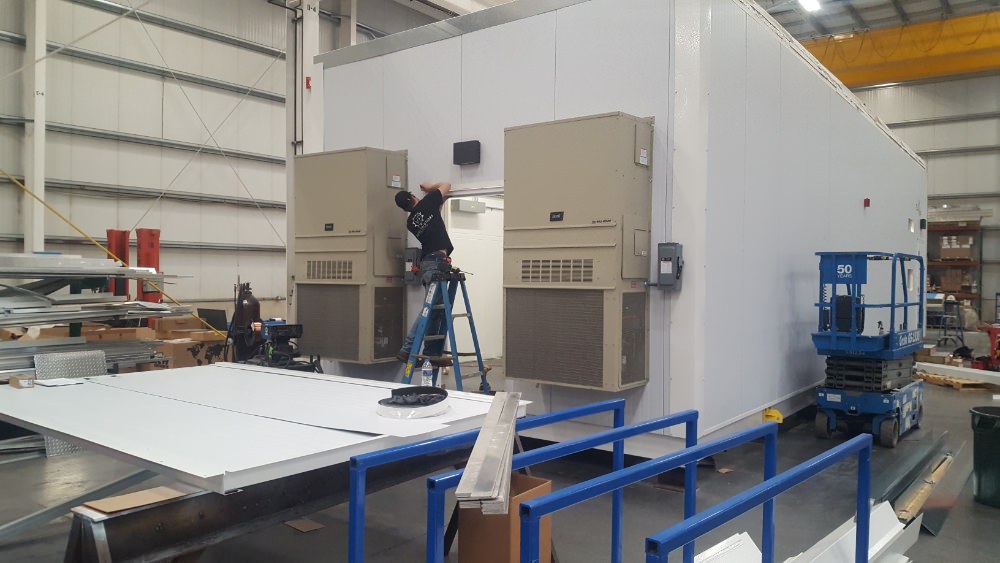

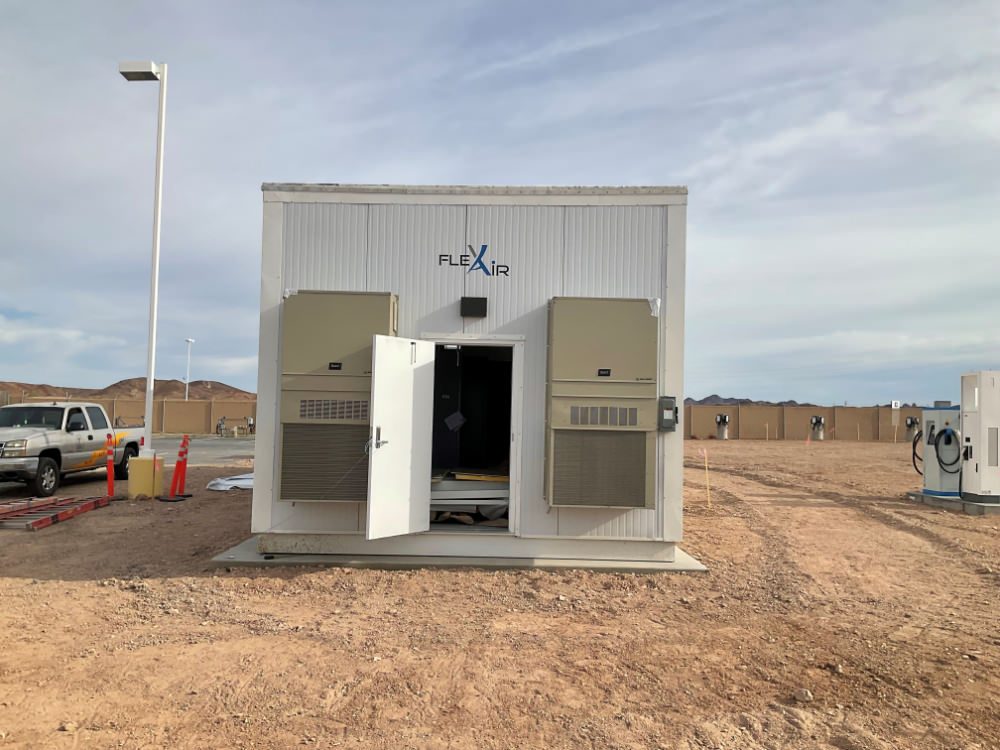

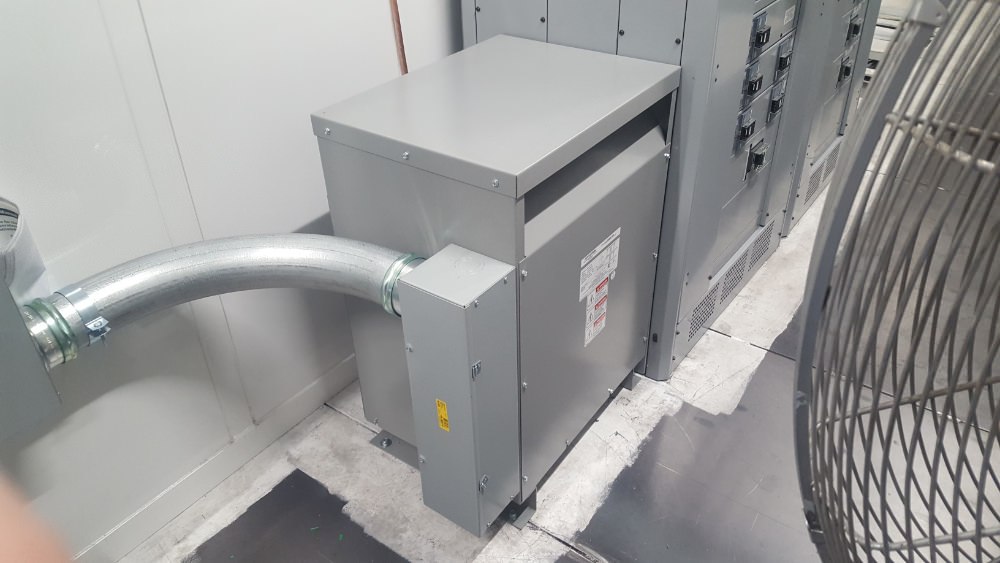

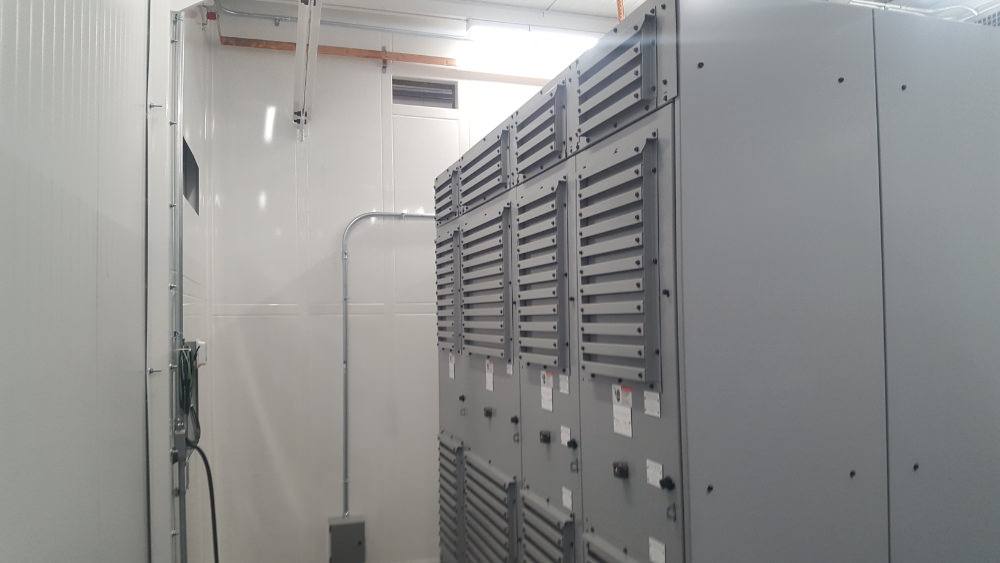

⦁ The enclosure was ready on the manufacturing floor when the gear arrived.
⦁ Shipped a “turnkey” unit within 4 weeks of receiving gear.
